How Solar Proposal Tools Feed ERP Workflows

How Solar Proposal Tools Feed ERP Workflows

I treat an accepted solar proposal as a starting point – not permission to purchase materials or send invoices. Before creating ERP records, I check the signed contract, customer ID, approved design, BOM, and payment terms.

The split is simple: your proposal tool owns the deal and design data. ERP handles project work and inventory alongside finance. Here’s how I keep that handoff on track:

  • Map the data: Define required fields, record IDs, approval checks, and who fixes errors.
  • Validate the deal: Match customers, create linked sales orders and projects, and prevent duplicates when transfers retry.
  • Control releases: Purchase from the final approved BOM and bill only when signed terms allow. Creating an invoice is not the same as recognizing revenue.
  • Test before scaling: Run 5–10 end-to-end flows, including revisions, cancellations, and retries. Review the results and integration scope with Blu Banyan.

My rule: <u>transfer approved data without rekeying, but keep purchasing and billing behind separate approval gates.</u>

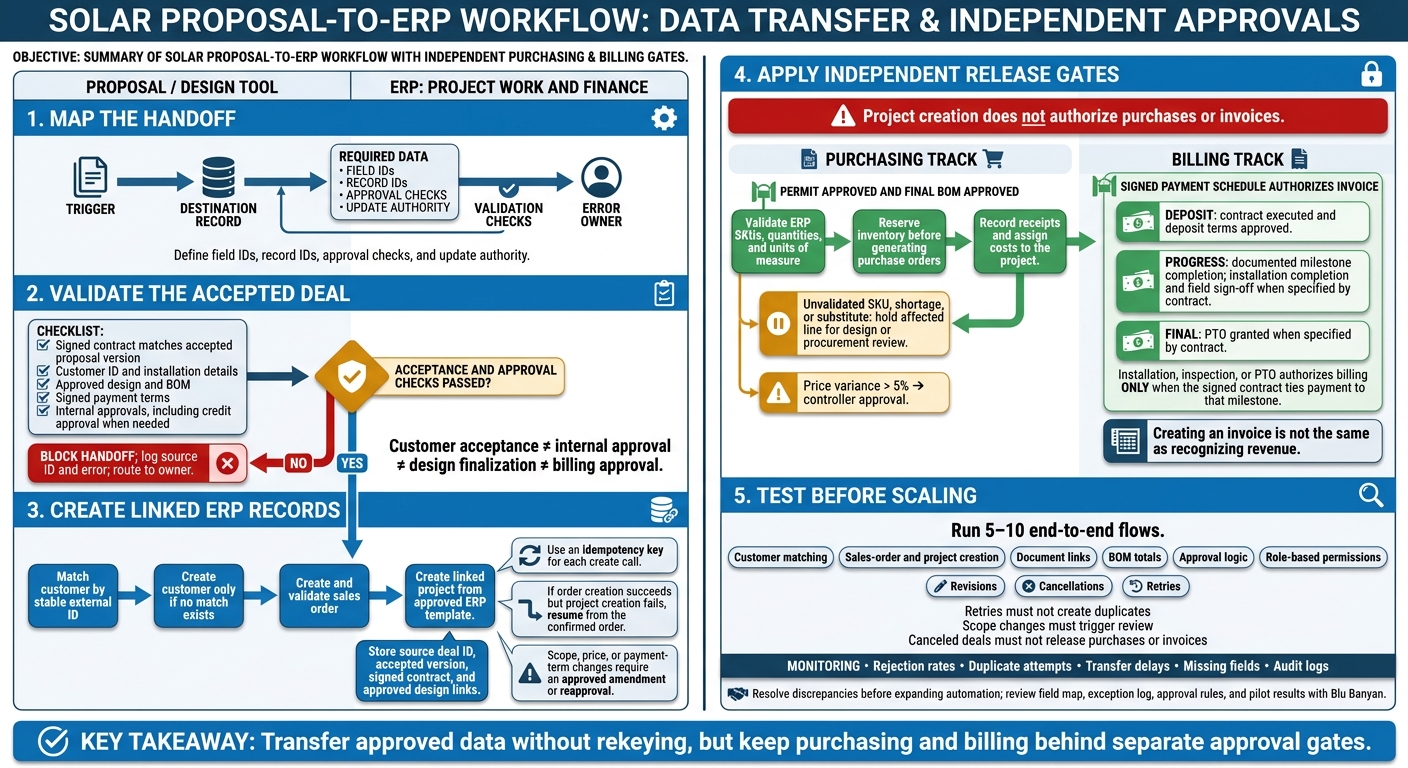

Solar Proposal to ERP: Workflow and Approval Gates
Solar Proposal to ERP: Workflow and Approval Gates

Step 1: Map Workflows and Data Fields

Build a handoff map before configuring the integration. For every transfer, identify the trigger, destination record, required data, validation checks, and person responsible for fixing errors. If validation fails, stop the transfer and log the source ID and error. Begin with the first ERP record created after acceptance.

Map the Workflow From Proposal to Billing

Keep customer acceptance, internal deal approval, design finalization, and billing milestone approval separate. Each is its own event. Use the workflow map to define when records can move to the next stage.

TriggerSource systemDestination recordTransferred dataOwnerException path
Customer signs contractProposal toolSales orderCustomer info, BOM, pricing, financing termsSales repCredit check fails → return to sales
Sales order approvedERPProject recordSite address, milestones, task templates, budgetProject managerMissing site data → return to design
Design finalizedProposal / design toolSales order updateFinalized BOM, equipment specsDesign engineerEquipment out of stock → procurement alert
Permit approvedAHJ registry / ERPPurchase orderFinal BOM, vendor detailsProcurement teamPrice variance > 5% → controller approval
Install marked completeMobile field appProject taskStatus, labor hours, serial numbers, photosField supervisorInspection fails → reschedule repair
PTO grantedUtility notificationInvoiceFinal balance, milestone completion dateControllerPayment dispute → collections review

Track release conditions separately from triggers. Purchasing may need both the final BOM and permit approval. Billing must follow the signed payment schedule. Installation completion, inspection, or PTO should authorize an invoice ONLY when the contract ties payment to that milestone.

Apply this same trigger-to-record logic when mapping fields below.

Map Fields and Assign Data Ownership

Build a field dictionary alongside the workflow map. The destination names below are labels – map each one to its ERP field ID. Specify whether a value is copied once, synchronized through an approved revision, or calculated by the ERP.

Proposal fieldERP destination fieldData typeTransformation ruleRequired statusUpdate authorityValidation rule
Customer IDCustomer external IDStringDirect map; prevent duplicatesRequiredSystemNo duplicate IDs
Accepted proposal IDSales-order external IDStringDirect map; copy-onceRequiredSales repMatch signed contract
Installation addressProject site addressAddressStandardize via AHJ Registry or USPS APIRequiredDesignVerify via AHJ Registry
System size (kW)Total kWDecimalRound to 2 decimal placesRequiredDesignMust match BOM total
Estimated yieldAnnual kWhIntegerDirect mapOptionalDesignPositive integer
Equipment list (BOM)Sales-order itemsList/sublistSync with ERP inventory item IDsRequiredProcurementMust exist in inventory
Design versionProject document linkURL or fileLink to latest design imagery or PDFRequiredDesignMust match approved revision
Total contract priceSales-order amountCurrencyFormat as USD, such as $125,000.00RequiredSales repMatch financing total
Financing providerProject financierPicklistMap to approved integrated partnersFinanced dealsFinanceProvider must be approved
Acceptance dateSales-order dateDateFormat as MM/DD/YYYYRequiredSystemCannot be a future date
Payment milestonesBilling schedule; milestone amountsControlled list; USD decimalCopy signed schedule; changes require approvalBefore billing setupControllerAmounts reconcile to contract

Scope IDs by source and record type, not by customer name or address. On retries, preserve accepted IDs and signed terms. Keep approved design revisions, inventory availability, purchasing status, tax calculations, and invoice balances under solar accounting and finance ERP control.

Step 2: Validate Deals and Create ERP Records

Check Deal Data and Match Customers

Use the field map from Step 1 to check the accepted deal before creating SolarSuccess ERP records. Confirm that the signed contract matches the accepted proposal version and that all required internal approvals are complete, including credit approval when needed.

Require customer and installation details, the final bill of materials (BOM), and approved design documents. Keep the sales scope separate from the procurement BOM.

Match the customer using a stable external ID from the proposal system. Create a new customer only if no match exists. Attach or link the signed contract and approved design documents. A DocuSign integration can help verify the contract [1].

Create the sales order for that customer. Check its lines, totals, and required documents before creating the linked project from the approved ERP template. Store the source deal ID, accepted version, and document links on the ERP records.

Set Rules for Approvals, Retries, and Changes

Failed acceptance or approval checks must block the handoff. After acceptance, any change to scope, price, or payment terms requires an approved amendment or reapproval. Keep the original agreement and revision history.

Use an idempotency key for each create call to prevent duplicate ERP records. If order creation succeeds but project creation fails, resume from the confirmed order rather than creating another one.

Limit retry updates to proposal-owned fields, and log transfer status and errors for auditability. Once the order passes validation, ERP can create the project and control purchasing and billing in Step 3.

Step 3: Set Up Projects, Purchasing, and Billing

Project setup, purchasing, and billing need separate release controls. A signed deal can create a project record without approving purchases or invoices. Define each release in ERP:

EventRequired Source StatusERP ActionAccountable TeamException Handling
Project setupSales order approvedCreate project record; sync customer, site, budget, and BOMSales / Project ManagerBlock setup if project data is missing
Purchasing releasePermit approved and BOM finalizedGenerate purchase orders; reserve inventoryProcurement TeamFlag SKU shortages or price variances
Deposit billingContract executed and deposit terms approvedGenerate deposit invoiceFinance / ControllerHold payment-dependent tasks until payment is confirmed
Progress billingInstall complete and field signed offInitiate progress invoiceField Supervisor / FinanceHold for missing photos or work logs
Final billingPTO grantedRelease final invoiceFinance / CollectionsFlag AHJ inspection failures or utility delays

Create Project Records and Track Costs

Create the ERP project record using the validated customer, contract, and BOM data from Step 2. Apply the ERP project template with the approved customer, site, budget, and project manager data. Fill in the customer ID, site address, approved BOM, and payment terms from the mapped proposal fields.

Keep estimated project costs in the budget until the work is completed and approved. The project manager maintains schedules, milestones, and task updates in ERP. Check permit, survey, and inspection status before releasing work that depends on them.

Release Purchasing From the Final BOM

Use the frozen, approved proposal BOM to map proposal SKUs, quantities, and units of measure to validated ERP items. Reserve inventory before generating purchase orders. If a SKU hasn’t been validated, is short, or needs a substitute, hold that line and send it back for design or procurement review.

Record receipts against the purchase orders and assign costs to the project budget. Once project setup and purchasing releases are controlled, billing follows the signed payment schedule.

Approve Billing by Terms and Milestones

Map the approved pricing and signed payment schedule from Step 1 into ERP billing terms. Deposit, progress, and final invoices must follow proposal-approved milestones, not ad hoc project updates.

Keep deposit billing separate from milestone billing. For installation- or PTO-based milestones, invoice only after documented installation completion or PTO, with evidence to support the release.

Invoice generation is not revenue recognition. Keep it separate from revenue recognition and other ERP accounting rules.

Conclusion: Test Controls Before Expanding Automation

Once your workflow map and field dictionary are in place, run a controlled pilot before expanding automation. An accepted proposal must still pass duplicate checks, finalized BOM purchasing controls, and billing approvals.

Pilot the Integration and Monitor Transfers

Test 5–10 end-to-end flows across a limited set of projects. Check customer matching, sales-order and project creation, document links, BOM totals, and approval logic before scaling. Reconcile proposal totals with ERP orders, and check approved equipment quantities against procurement requirements.

Include revisions, cancellations, and retries in your tests. Retries must not create duplicates. Scope changes must trigger review, and canceled deals must not release purchases or invoices. Also test role-based permissions and purchasing and billing approval gates.

Give each workflow a process owner and each exception an owner. Monitor rejection rates, duplicate attempts, transfer delays, missing fields, and audit logs. Expand only when discrepancies are resolved and the tested handoffs consistently meet your acceptance criteria.

Review Integration Requirements With Blu Banyan

Blu Banyan‘s SolarSuccess is a NetSuite-based ERP for solar installers. Blu Banyan provides implementation, customization, and integration services.

Use your pilot results to check what should be automated next. Bring your field map, exception log, approved deals, approval rules, and pilot results to Blu Banyan for review. Confirm the integration scope, configuration requirements, and who owns each exception.

FAQs

How do I handle BOM changes after purchasing starts?

When a bill of materials (BOM) changes after purchasing begins, SolarSuccess handles updates through integrated change order workflows. Project-specific document management and version tracking keep BOM revisions in sync with procurement schedules and financial records.

The platform automatically adjusts procurement requirements and inventory needs in real time to prevent over-ordering. Tracking each revision keeps project costing and profitability data accurate throughout the project.

What if my ERP transfer only partially succeeds?

A partially successful ERP transfer usually points to a data synchronization issue that needs immediate attention. Blu Banyan’s SolarSuccess, built on NetSuite, uses stage-gate workflows to check required data before a project moves forward. These checks keep incomplete records from triggering procurement or billing.

If a transfer fails, the platform’s integrated architecture helps teams find missing information in the records. That keeps sales, finance, and other departments working from a single source of truth.

How do I handle cancellations after a deposit is paid?

Update the project status in the CRM to automatically notify the billing team so they can process any needed refunds or customer account adjustments.

SolarSuccess connects sales orders, project tasks, and accounting events in your ERP. Its cancellation workflow lets you reverse project milestones and financial records, stop procurement, update inventory availability, and adjust financial reporting. That keeps your financial records in step with changes to the project.
